L&G Building & Concrete review: $98,750, 209 days, no finished building

In February 2026 I signed a contract with L&G Building & Concrete of Asheboro, North Carolina, for a 50×80 metal building and the concrete under it. This site is my record of what happened next: the contract, the money, the photos, the inspections and the public records, laid out so you can check every piece yourself.

Company
L & G Building and Concrete LLC, Asheboro, NC
Project
Certified 50×80×16 metal building, two lean-tos, slab and footers
Where
Alexander County, North Carolina
Signed
February 20, 2026
Contract total
$98,750 ($50,551 building, $48,199 concrete)
Paid so far
About $93,000
Status, Sept. 17, 2026
Cracked slab, half a frame, no roof, no walls
Tape-measure timeline of the project, February to September 2026Order written February 12, 2026. Contract signed February 20, 2026 for $98,750. In April the footings failed inspection and the slab preparation measured about four and a half inches. July 10 marks twenty weeks, the contract’s outside estimate for engineered plans. The August 29 install date was moved by text. The crew arrived September 3. On September 17, day 209, the building was half framed and work had stopped.FebMarAprMayJunJulAugSep209 days from signing. April dates are approximate until the county inspection file is released.Feb 12Order written upFeb 20Contract signed: $98,750$19,700 deposit by wireJul 10 (week 20)L&G’s contract says engineeredplans “can take up to 20 weeks”Sep 17 (day 209)Half a frame. No roof,no walls. Work stopped.AprilFootings fail inspection.Slab prep measures 4½ in.Aug 29Install date. Moved by textto “Monday at latest”
One tick is one day. Flags mark only the dates I can document today. Pink is my own record, orange is L&G’s own statement.

What about $93,000 has bought so far

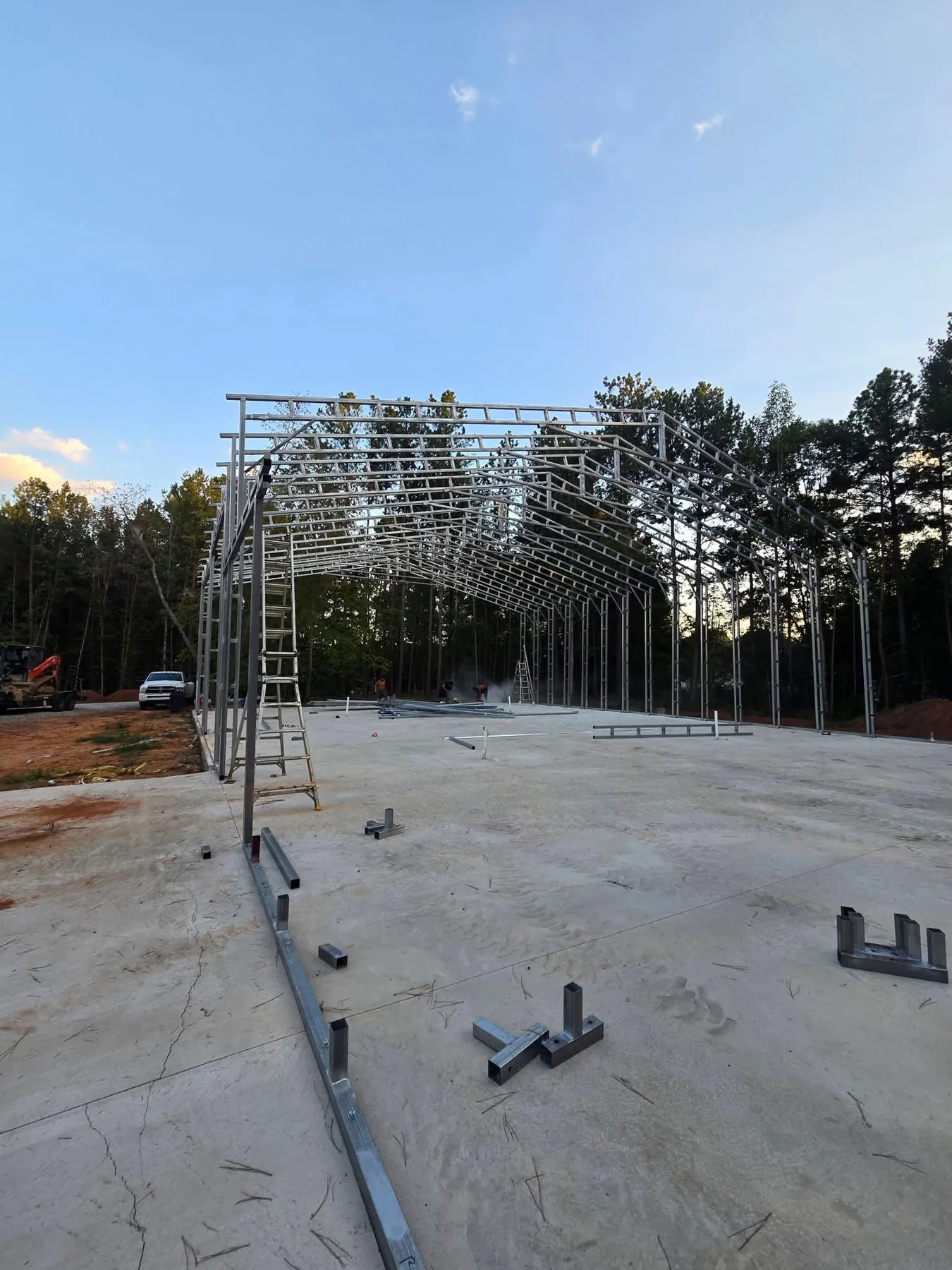

Partly erected steel frame of a 50 by 80 metal building on a concrete slab, with no roof or wall panels, loose steel parts on the slab and a crack in the foreground
P-04The building as it stood when work stopped: part of the frame up, no roof or wall panels, loose parts on the slab. A crack in the slab is visible at lower left. Early September 2026.

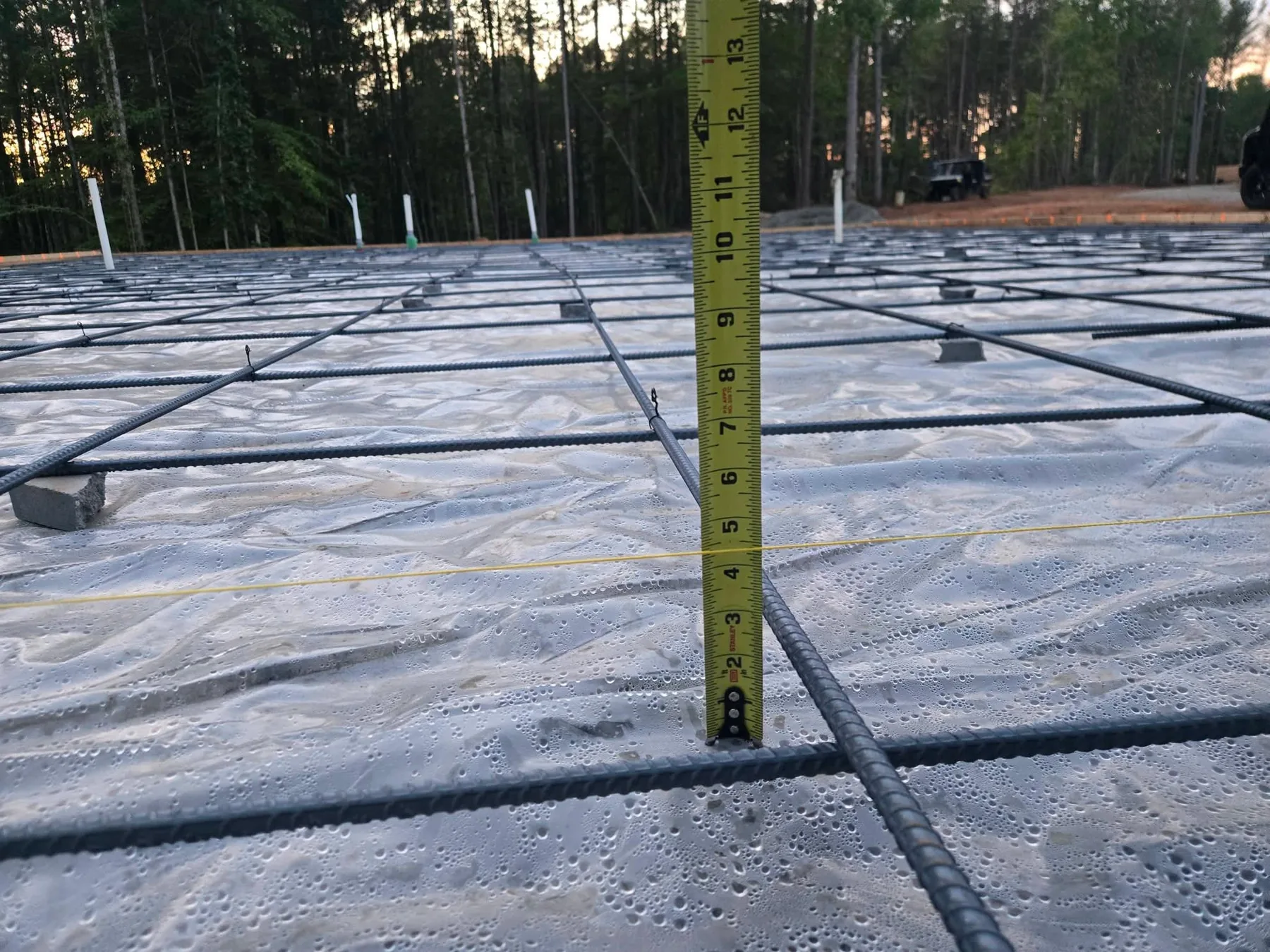

Tape measure standing on the vapor barrier of a rebar-reinforced slab before the pour, with a yellow string line crossing the tape at about four and a half inches
P-01Before the pour. The tape stands on the vapor barrier, and the yellow string line crosses it at about 4½ inches. The white plumbing stub-ups in the background are standing straight. April 2026, before the pour.

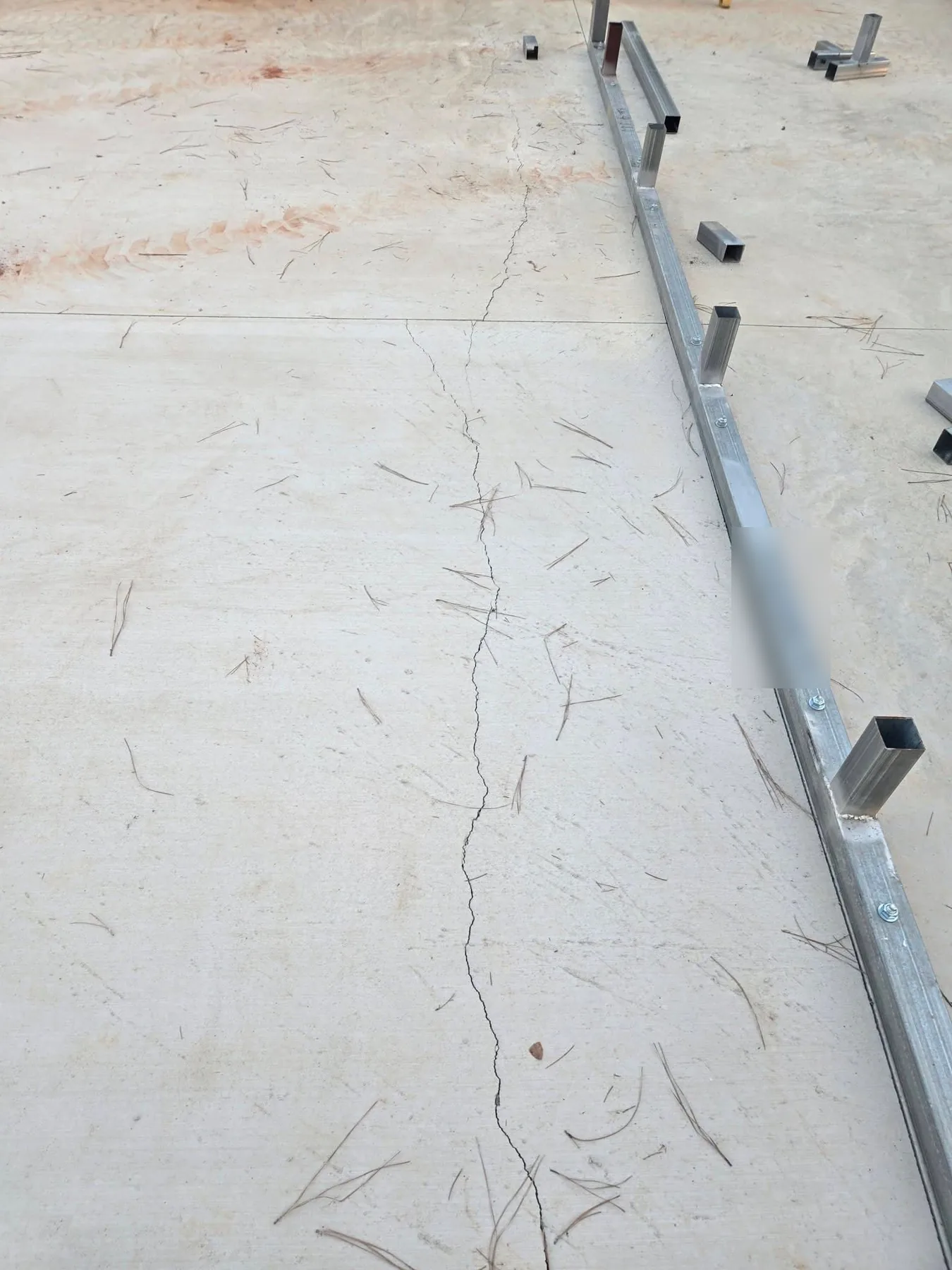

A long crack running across the concrete slab and through a saw-cut control joint, next to the steel base rail of the building
P-03A crack running from the front of the picture to the back, crossing a saw-cut control joint, beside the building’s base rail. Handwriting on the rail is blurred for privacy. Nothing else in the image is altered. Early September 2026.

Why I built this instead of leaving a one-star review

A one-star review is easy to write and easy to dismiss. Nobody reading it can tell whether the customer was unreasonable or the company was. I would rather show you the paperwork.

I paid for a certified building with engineered plans, a 6-inch slab and inspected footings. In April the footings were dug to 12 inches when L&G’s own plans called for 14, failed the county inspection, and I was charged extra for the fix, then charged for a concrete pump that was on no invoice I had signed. When I was told the pad was ready to pour I measured about 4½ inches. The building was delayed for months and my requests for a refund were refused.

In September a crew finally arrived, five days after the date I was given, put up half the frame, left my plumbing stub-ups leaning and gouged, and stopped. L&G then told me I needed to supply a different telehandler, despite having texted me that anything beyond my one-week rental “runs through us,” and asked for the installation payment that my paperwork says is due at completion. I have paid about $93,000.

Some of that is documented on this site today. Some of it is waiting on records I have requested from the county and on files I am still organizing, and those spots are marked so you know the difference. If L&G finishes the job or shows me I have something wrong, that goes on the site as well.

What the contract says, next to what I have

Left column: L&G’s own signed paperwork. Right column: my account of my own project. Photos and texts are linked. County records and payment confirmations are being added as they are released.

ItemThe contractMy project
Slab thicknessCompany statementThe concrete contract specifies 6 inches under the building and 4 inches under each lean-to, at 3,500 psi, for $37,380.My project recordTold the pad was ready to pour, I stood a tape on the vapor barrier. The string line crossed it at about 4½ inches. Photo P-01.
FootingsCompany statement“1x1 footers” plus two strip footers for $9,594, marked “inspection required.” If the inspector wants them deeper, the customer pays.My project recordThe plans L&G gave me call for 14-inch footings. The crew dug 12. They failed inspection and I was charged extra for the correction, then for a concrete pump that is on no invoice I signed. County reports requested.
Concrete qualityCompany statement“L&G Building and Concrete does not offer warranty on concrete.” The sheet says cracks “are bound to happen.”My project recordA long crack that runs through a control joint, five months after the pour. Photo P-03. Decide for yourself whether you would accept it on a $48,199 concrete job.
TelehandlerCompany statementOrder form: customer provides the lift, for one week. By text, L&G: “if we need it long it runs through us” and “if we need it longer I’ll get my own” lift.My project recordI paid $2,000 for the rental. The crew came five days late, put up half the building, and I was told to supply a different telehandler. Read the texts.
Damage on siteCompany statementThe customer agrees to hold L&G harmless for damage to “submerged lines, pipes, cables.”My project recordPlumbing stub-ups left leaning and gouged, with tire tracks on the slab around them. They were upright before the pour. I contend it happened during L&G’s install. Photos.
RefundsCompany statement“All down payments are non refundable. … All sales are final.”My project recordDuring months of delay I asked repeatedly for my money back so I could hire someone else. Refused.
Finish dateCompany statementNone. The packet has no start date, no completion date and no remedy for delay.My project recordDay 209 and counting. L&G has asked for the $8,568 installation payment, which its own Balance Breakdown says is due “upon building completion.”

General contractor license: still checking

Official record

North Carolina requires a general contractor license when a project is $40,000 or more. My project was $98,750. I have not yet been able to match a license to L&G Building and Concrete for this job. That is not the same as saying none exists. I have asked the board directly and will post its answer here, whichever way it comes out.

What I can tell you today is what the contract says: “we are manufacturers not contractors.” The permit for this project is in my name, because the contract made permits my job.

How North Carolina’s $40,000 license rule and owner-builder permits work

I am not the only one who has written about this company

Other L&G customers have posted public reviews and complaints describing delays, cracked concrete, lift charges that were not in their contracts, and payment standoffs. L&G has answered several of them and disputes parts of what they say. There is a five-star review in there too.

I summarize each one with the company’s reply beside it and a link to the original. They are other people’s allegations. I cannot verify them and I do not present them as fact.

Buying a metal building near Hickory or Asheboro?

L&G’s contract made the permit my job, and I had to learn how my county works on my own. I have written up what I found for the counties around my project and around L&G’s home base, with each office’s contacts checked against its own website.

Alexander County · Catawba County · Caldwell County · Burke County · Iredell County · Randolph County · Guilford County

There are also guides built on my real numbers: what a metal building costs in NC, what the slab costs, how to check slab thickness and footing depth.

How to read this site

Every claim carries one of four flags, so you always know whose word you are reading.

Official record
Government, court or regulator records. Linked to the original.
My project record
My contract, photos, payments, messages and what I saw on my own lot.
Company statement
L&G’s own words: its contract, website or written replies.
Third-party report
Reviews and complaints by other people. Allegations, not findings.

Questions people ask about L&G Building & Concrete

Is this the official L&G Building & Concrete website?

No. This is an independent review written by a customer. It is not affiliated with, sponsored by or endorsed by L&G Building & Concrete LLC of Asheboro, North Carolina. The company’s own website is lgbuildingsandconcrete.com.

What did you hire L&G Building & Concrete to do?

A certified 50×80×16 vertical-roof metal building with two 12-foot lean-tos, plus the concrete: a 6-inch slab under the building, 4-inch slabs under the lean-tos, footers, grading and a vapor barrier. The signed project total was $98,750.

Did L&G finish the building?

Not as of September 17, 2026, which is 209 days after I signed. A crew arrived on September 3, five days after the scheduled date, put up about half of the steel frame and stopped. There is no roof and there are no walls. I have paid about $93,000. I will update this site if that changes.

Does L&G Building & Concrete warranty its concrete?

No. The contract packet includes a separate sheet that the customer signs, stating that L&G does not offer any warranty on concrete. The building carries a 90-day workmanship warranty and a 10-year sheeting warranty.

Did you get the 6-inch slab you paid for?

I do not know yet. My contract specifies 6 inches under the building. When I was told the pad was ready to pour, I stood a tape measure on the vapor barrier and the string line crossed it at about 4½ inches. The photo is on this site. Only core samples can show what the finished slab measures, and I intend to have them taken.

Who pays for the telehandler on an L&G Building & Concrete job?

On my order the lift was listed as customer-provided at $0, for one week. By text, L&G’s installation contact told me that if the crew needed it longer “it runs through us” and “I’ll get my own” lift. I paid $2,000 for the rental. The crew came five days late, and after half the building was up I was told to supply a different telehandler. The texts are published on the telehandler page.

Is the deposit refundable?

The terms say all down payments are non-refundable and all sales are final. One page allows a refund, minus the salesperson’s commission, if your county sends a written letter rejecting your permit. My deposit was $19,700. During months of delay I asked for a refund more than once and was refused.

Is L&G Building & Concrete a licensed general contractor in North Carolina?

I do not know yet, and I am not going to guess. North Carolina requires a general contractor license for projects of $40,000 or more. I have not yet matched a license to the company for my job and have asked the licensing board to confirm. The contract itself says L&G is a manufacturer and not a contractor. I will publish the board’s answer.

Why should I believe you?

You do not have to. Every claim on this site is tagged by where it comes from: official records, my own project records, L&G’s own statements, or other customers’ reports. Where I am giving an opinion I say so, and where a document is still on its way I say that too.

What if L&G says something here is wrong?

It can send documentation to the corrections address on the company response page. If reliable records show I have a fact wrong, I will fix it and note the correction publicly.
